Attend a pop-up event to learn more
To learn more about this project and to speak with project staff directly, consider attending one of eight pop-up Open House events to share your thoughts on the 10 corridors under consideration.
Project staff will be hosting pop-up Open Houses at the following locations to speak with transit customers and the broader community to answer project questions and gather comments.
Pop Up #1: Brooklyn Center Transit Center (2900 County Rd. 10, Brooklyn Center) July 24, 2 - 4 p.m.
Pop Up #2: Chicago Ave. & Lake St. Intersection (Minneapolis) July 26, 11 a.m. - 1 p.m.
Pop Up #3: Columbia Heights Transit Station (4099 Central Ave. NE, Columbia Heights) July 29, 2 - 4 p.m.
Pop Up #4: Sun Ray Transit Station (463 Pedersen St., St. Paul) July 30, 2 - 4 p.m.
Pop Up #5: 66th St. & Nicollet Ave. Intersection (Richfield) Aug. 7, 2 - 4 p.m.
Pop Up #6: University Ave. & Snelling Ave. Intersection (St. Paul) Aug. 9, 11 a.m. - 1 p.m.
Pop Up #7: Mall of America Transit Station (60 E. Broadway, Bloomington) Aug. 12, 2 - 4 p.m.
Pop Up #8: Rosedale Transit Center (1024 Rosedale Shopping Center, Roseville) Aug. 13, 2 - 4 p.m.
Metro Transit is selecting the next planned arterial bus rapid transit lines
The Arterial BRT Plan Update will identify the next three planned arterial bus rapid transit (BRT) lines – the J, K, and L lines – planned to open between 2030 and 2035. These lines will join the growing METRO network of fast, frequent, all-day service between comfortable stations with enhanced amenities.
The Plan Update began with 17 candidate corridors and will narrow down to the J, K, and L lines through technical evaluation, public feedback, and coordination with cities, counties, and MnDOT.
View the initial candidate corridors
View the project fact sheet

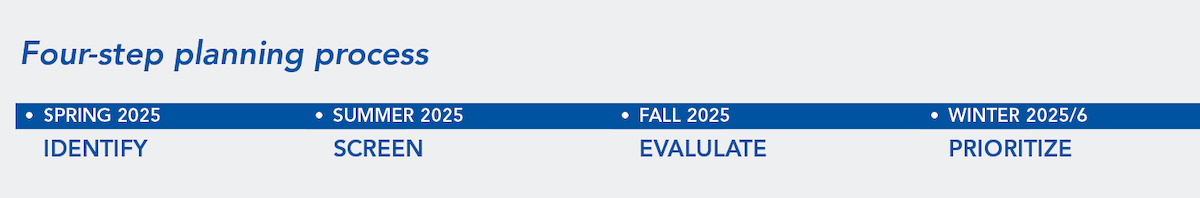

Four step planning process
To identify the J, K, and L lines, the Plan Update will follow a four-step planning process, narrowing down from the initial candidate corridors to the J, K, and L lines. This work is planned to conclude by the end of 2025.
- Step 1 – Identify (Spring 2025): Metro Transit has identified 17 candidate corridors for consideration. Learn how the candidate corridors were identified.
- Step 2 – Screen (Summer 2025): Apply screening criteria to narrow the candidates down to the most promising corridors for additional consideration.
- Step 3 – Evaluate (Fall 2025): Develop the most promising corridors in more detail and rank them using technical evaluation criteria.
- Step 4 – Prioritize (Winter 2025/6): Apply readiness criteria and coordinate with planned roadway projects to prioritize the next three lines as the J, K, and L lines.
Opportunities to review and provide feedback will follow each step. Please subscribe to the Arterial BRT Plan Update newsletter to stay up to date and learn more about opportunities to provide feedback.
